Construction Complete! - Retail Suite DC-2-03

Multi-Million Dollar Construction/expansion

7,500 sqft of data space available - Summer 2019

Retail Suite DC-2-03   Data Holdings has completed construction and commissioning of the latest Retail Data Center Suite DC-2-03  Commissioning on the suite was completed 8-9-2019  Suite is designed to support 250 new cabinet positions with power and cooling available to support 2kW – 25kW of demand per cabinet  Fully tested during commissioning at 110% of designed power load , UPS, and Critical Cooling.  Ready for customers to begin their continued data center initiatives, and deployment August 19 2019  Contact Data Holdings today to begin your introductions into Wisconsin’s World Class Data Center

Retail Suite DC-2-03

Data Holdings has completed construction and commissioning of the latest Retail Data Center Suite DC-2-03

Commissioning on the suite was completed 8-9-2019

Suite is designed to support 250 new cabinet positions with power and cooling available to support 2kW – 25kW of demand per cabinet

Fully tested during commissioning at 110% of designed power load , UPS, and Critical Cooling.

Ready for customers to begin their continued data center initiatives, and deployment August 19 2019

Contact Data Holdings today to begin your introductions into Wisconsin’s World Class Data Center


Week of April 29th - May 3rd, 2019   Our bay is cleared out and ready to get underway for a new makeover.

Week of April 29th - May 3rd, 2019

Our bay is cleared out and ready to get underway for a new makeover.


Week of May 6th - May 10th, 2019   Construction is underway. East walls have studs and electrical runs ready for some drywall.

Week of May 6th - May 10th, 2019

Construction is underway. East walls have studs and electrical runs ready for some drywall.


Week of May 13th - May 17th, 2019   Drywall is completed and ready for a fresh painting. Electrical and cooling runs getting completed for under the 3 foot raised flooring.

Week of May 13th - May 17th, 2019

Drywall is completed and ready for a fresh painting. Electrical and cooling runs getting completed for under the 3 foot raised flooring.


Week of May 20th - May 24th, 2019   Paint on drywall is completed, cooling runs are completed and next week flooring starts getting put in.

Week of May 20th - May 24th, 2019

Paint on drywall is completed, cooling runs are completed and next week flooring starts getting put in.

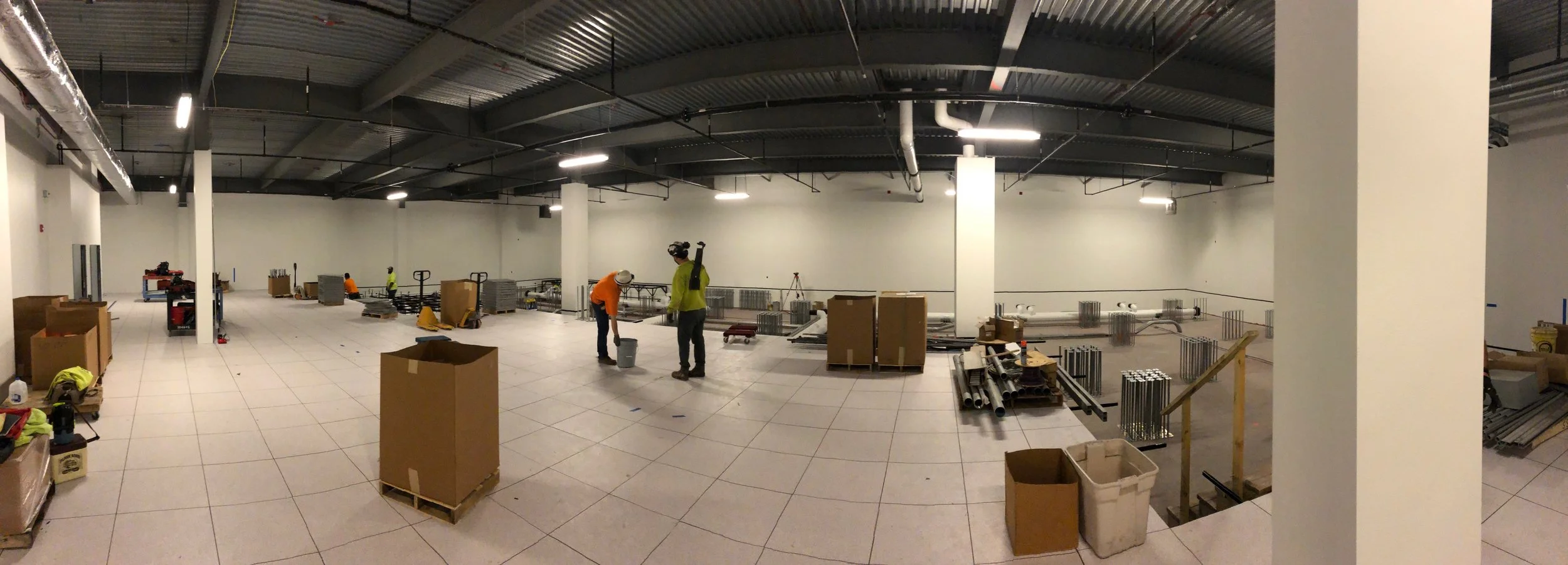

Week of May 27th - May 31st, 2019   The room is starting to come together. 3 feet of raised flooring is being added and should be completed the first week of June.

Week of May 27th - May 31st, 2019

The room is starting to come together. 3 feet of raised flooring is being added and should be completed the first week of June.

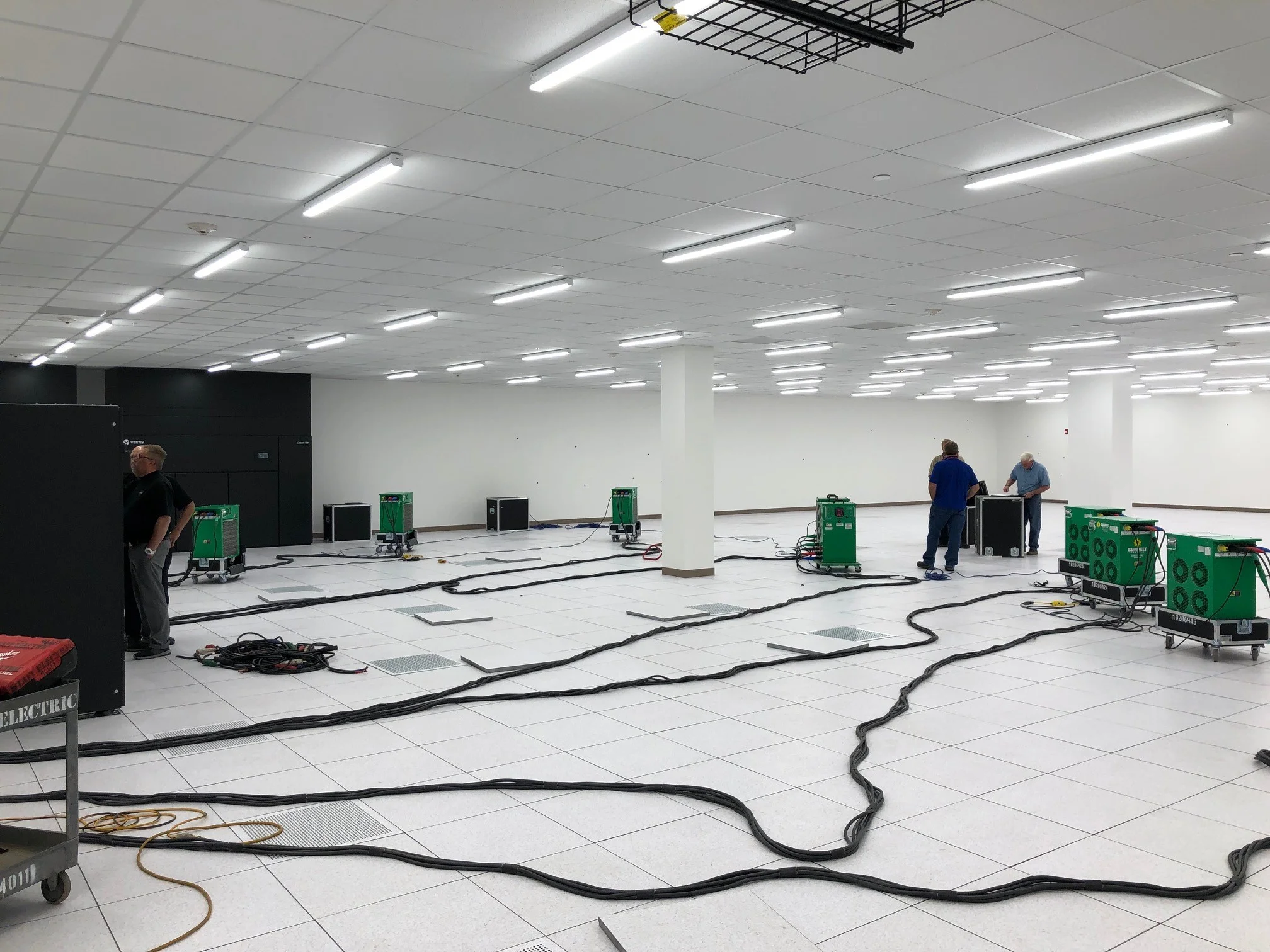

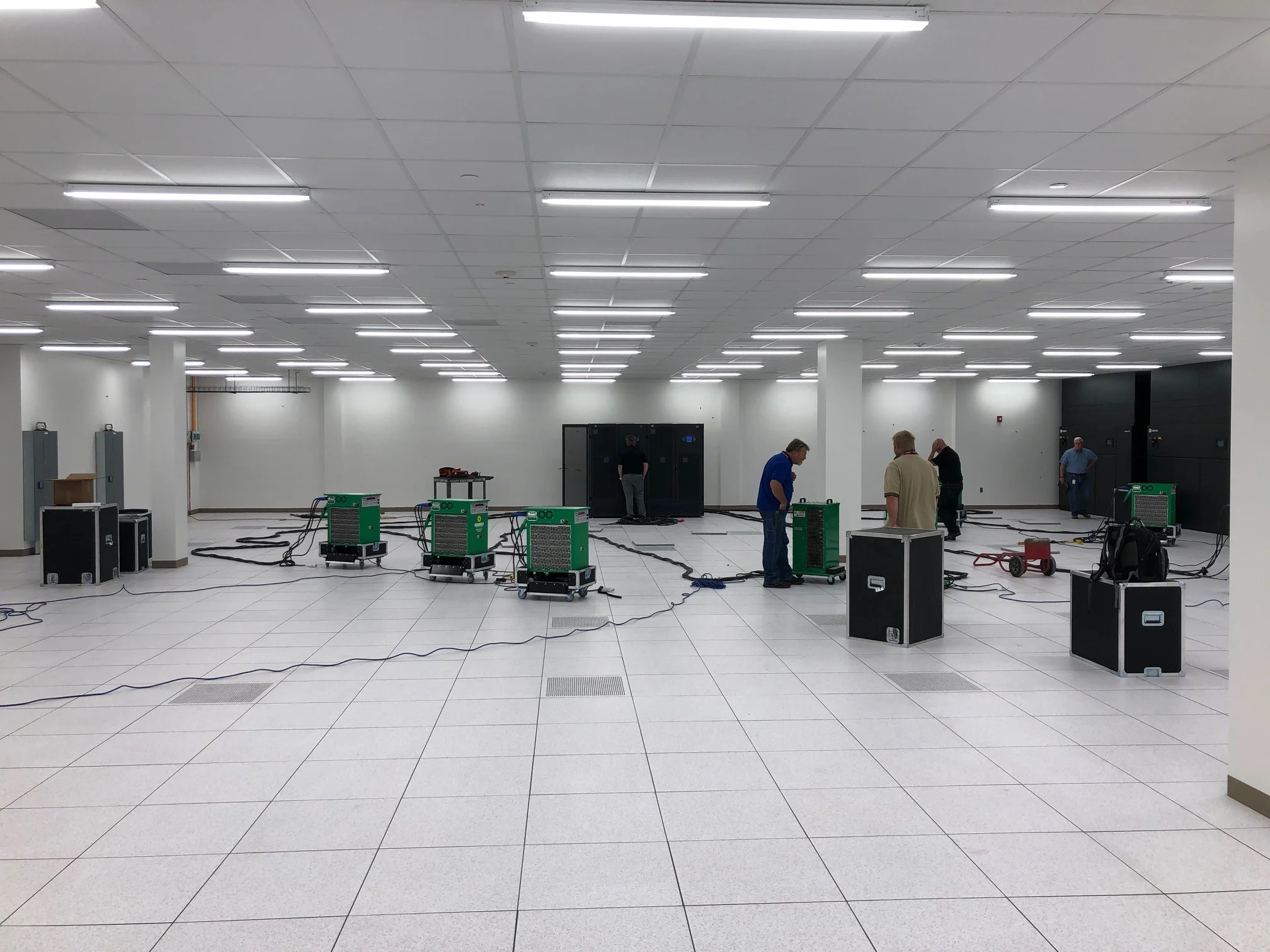

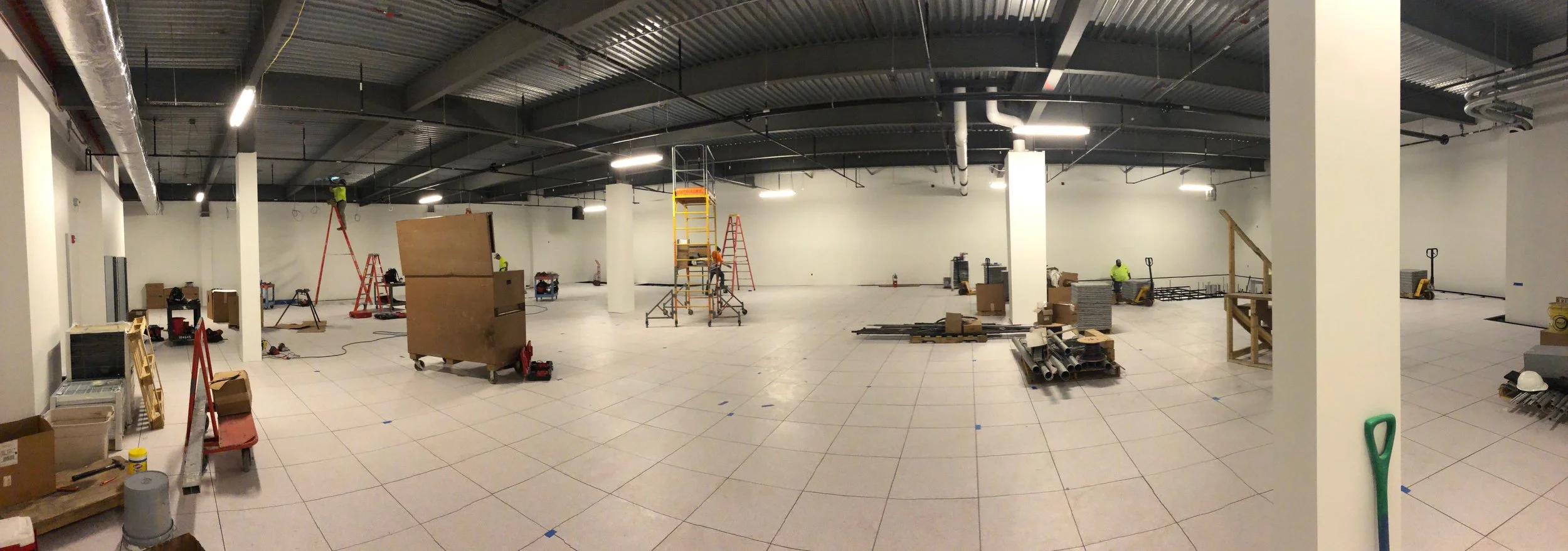

Week of June 3rd - June 7th, 2019   Almost two weeks of construction and the flooring is complete.

Week of June 3rd - June 7th, 2019

Almost two weeks of construction and the flooring is complete.


Week of June 10th - June 14th, 2019   Fire protection Vesda (Very Early System Detection Agent) and electrical for lighting being installed.

Week of June 10th - June 14th, 2019

Fire protection Vesda (Very Early System Detection Agent) and electrical for lighting being installed.


Week of June 17th - June 21st, 2019   Power supply/breaker boxes, uninterupted power supplys, cooling/air conditioning and ceiling grid being installed.

Week of June 17th - June 21st, 2019

Power supply/breaker boxes, uninterupted power supplys, cooling/air conditioning and ceiling grid being installed.


Week of June 24th - June 28th, 2019   Ceiling gride complete, lighting set into place and ready for ceiling tiles.

Week of June 24th - June 28th, 2019

Ceiling gride complete, lighting set into place and ready for ceiling tiles.

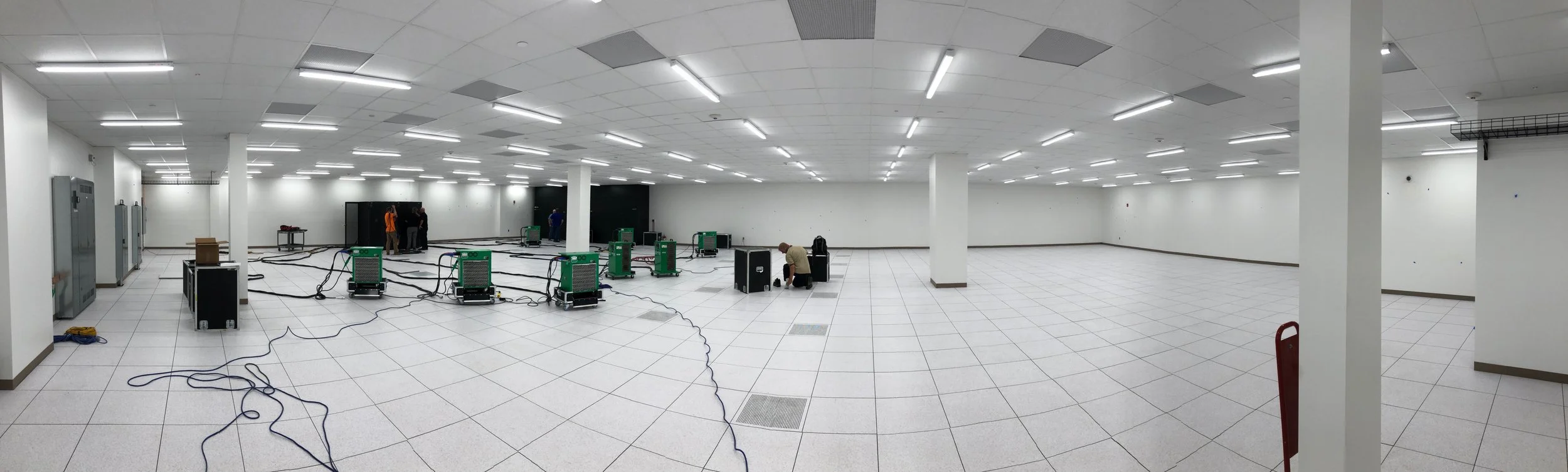

Week of July 1st - July 5th, 2019   We are ahead of schedule! Construction is nearly complete and we should be ready by the end of next week. Just need to put a good spit shine on things and we will be ready to start adding cabinets to this multi-million dollar addition. Customers are ready and we can’t wait. Very Exciting!!

Week of July 1st - July 5th, 2019

We are ahead of schedule! Construction is nearly complete and we should be ready by the end of next week. Just need to put a good spit shine on things and we will be ready to start adding cabinets to this multi-million dollar addition. Customers are ready and we can’t wait. Very Exciting!!

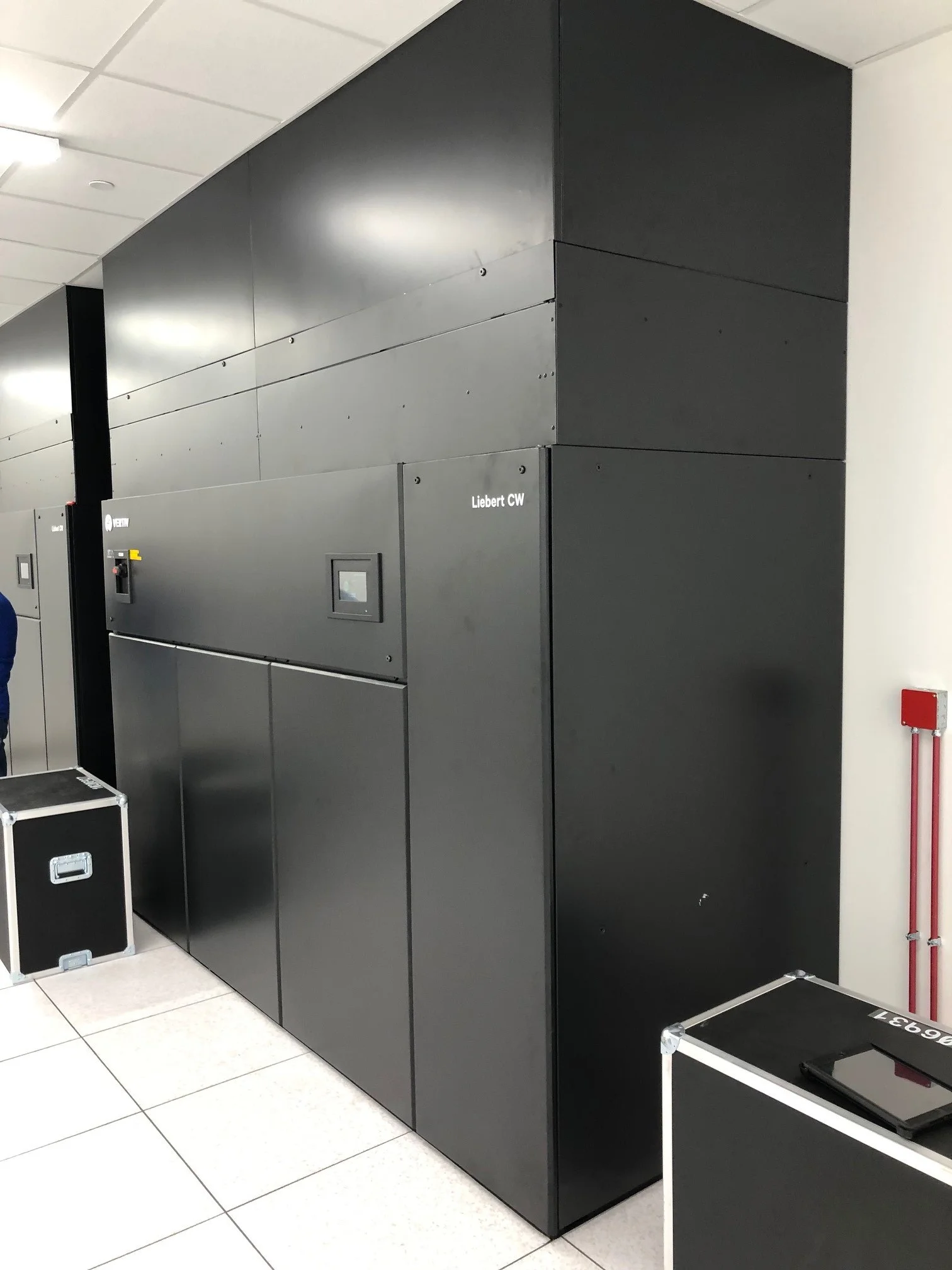

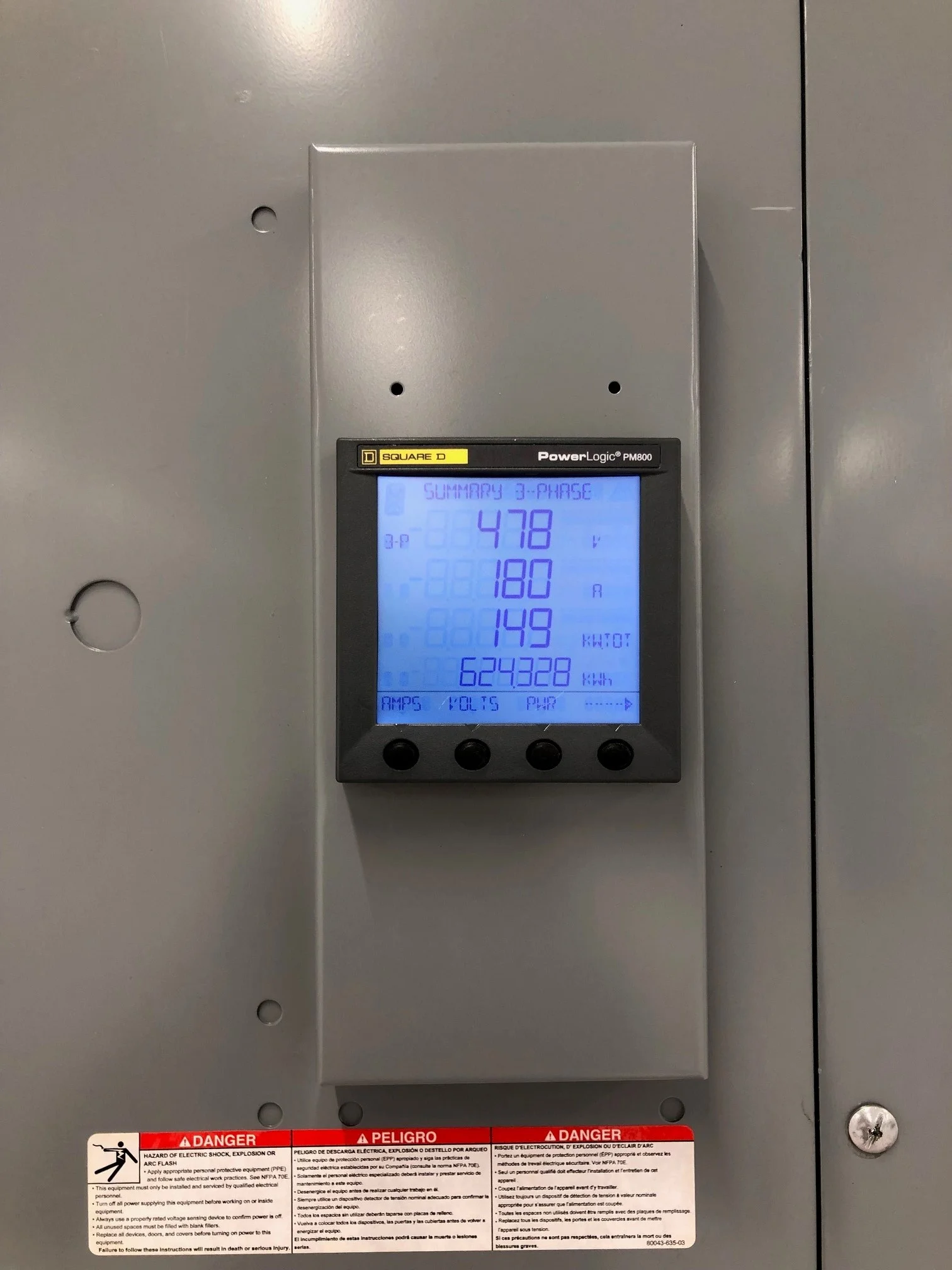

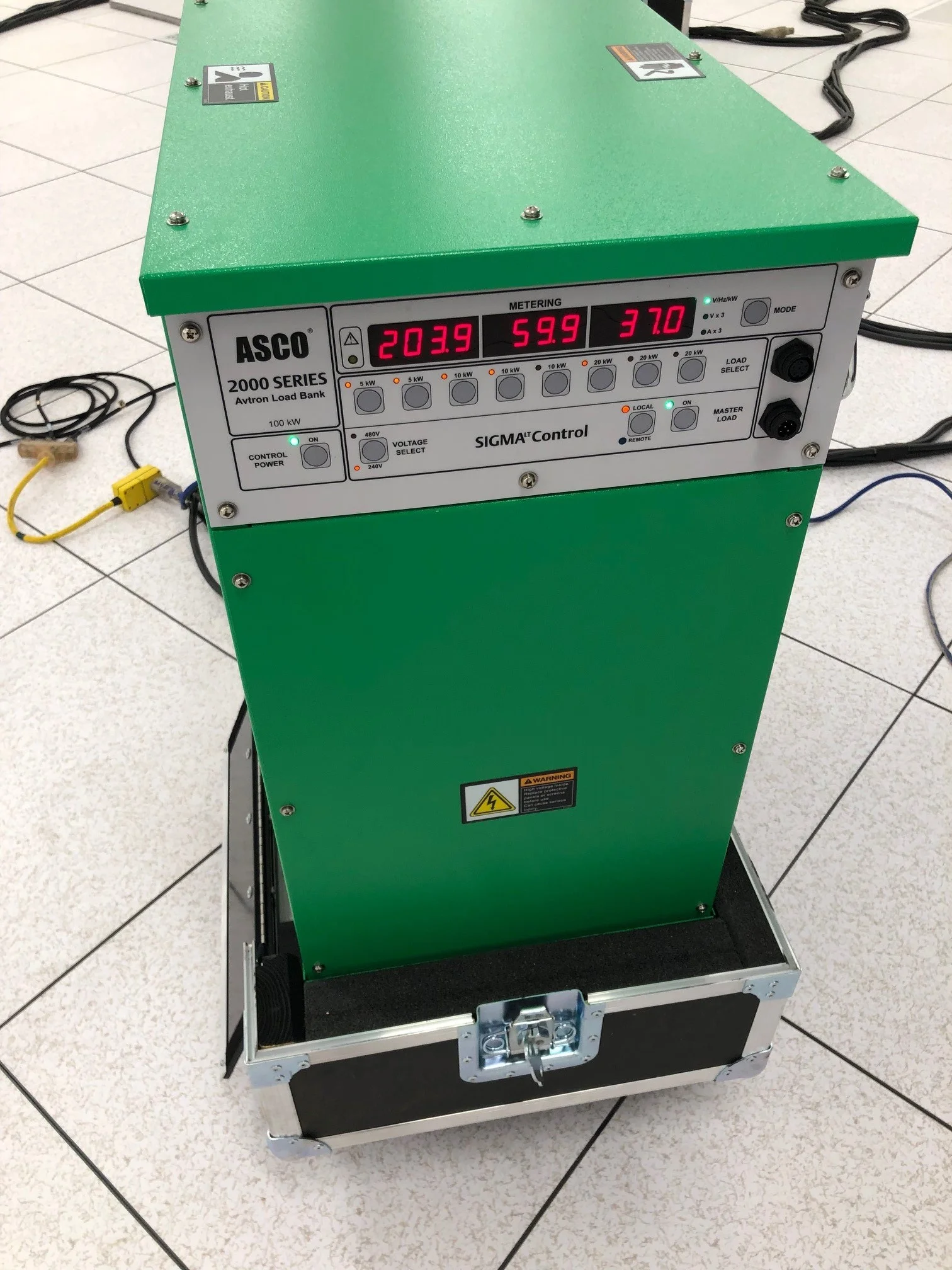

Week of August 5th - August 9th, 2019   800 kW of Resistive Load Banks installed for teting of UPS , PDU’s and Cooling. Suite tested to 110 % of design

Week of August 5th - August 9th, 2019

800 kW of Resistive Load Banks installed for teting of UPS , PDU’s and Cooling. Suite tested to 110 % of design

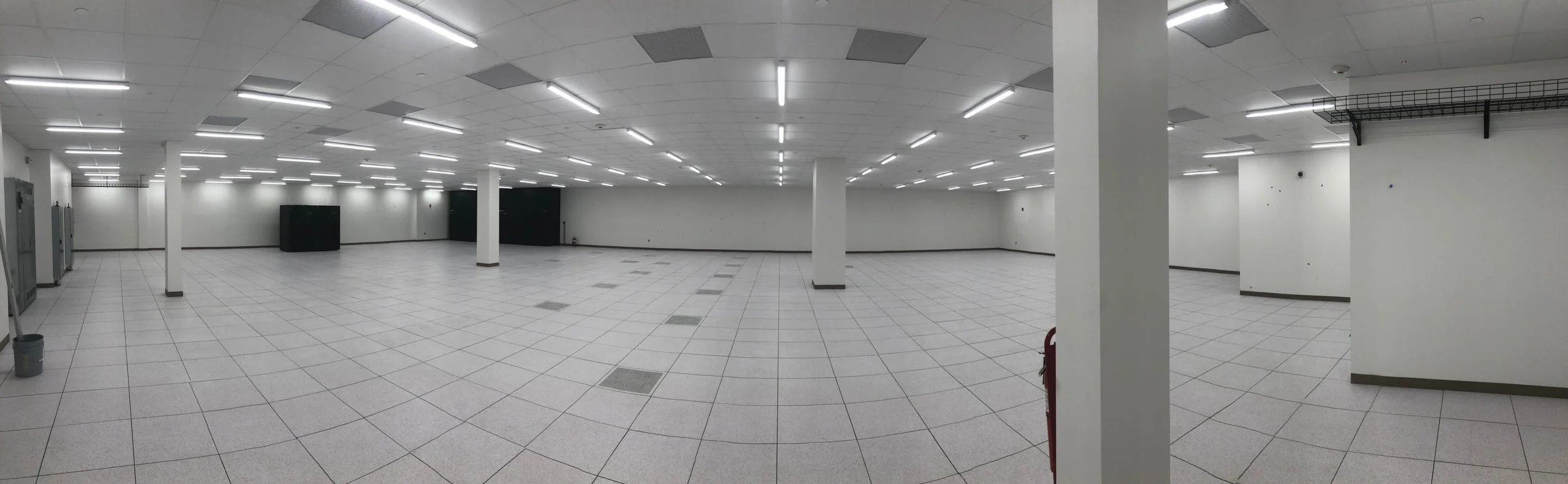

Week of August 5th - August 9th, 2019    Construction Complete    Retail Suite DC-2-03   Data Holdings has completed construction and commissioning of the latest Retail Data Center Suite DC-2-03  Commissioning on the suite was completed 8-9-2019  Suite is designed to support 250 new cabinet positions with power and cooling available to support 2kW – 25kW of demand per cabinet  Fully tested during commissioning at 110% of designed power load , UPS, and Critical Cooling.  Ready for customers to begin their continued data center initiatives, and deployment August 19 2019  Contact Data Holdings today to begin your introductions into Wisconsin’s World Class Data Center

Week of August 5th - August 9th, 2019

Construction Complete

Retail Suite DC-2-03

Data Holdings has completed construction and commissioning of the latest Retail Data Center Suite DC-2-03

Commissioning on the suite was completed 8-9-2019

Suite is designed to support 250 new cabinet positions with power and cooling available to support 2kW – 25kW of demand per cabinet

Fully tested during commissioning at 110% of designed power load , UPS, and Critical Cooling.

Ready for customers to begin their continued data center initiatives, and deployment August 19 2019

Contact Data Holdings today to begin your introductions into Wisconsin’s World Class Data Center
